LNG power projects face multiple hurdles

LNG power projects in Vietnam are currently grappling with many obstacles, ranging from bureaucratic delays to issues with power purchase agreements (PPAs), leading to significant project implementation slowdowns.

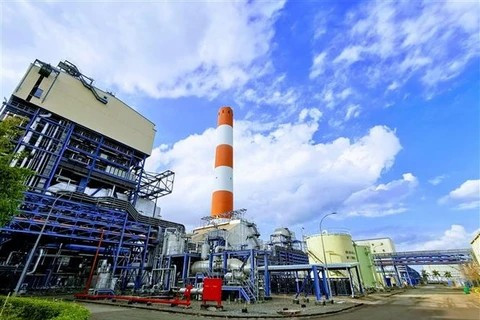

A LNG power facility in the central province of Nghe An (Photo: VNA)
A LNG power facility in the central province of Nghe An (Photo: VNA)

Hanoi (VNA) - LNG power projects in Vietnam are currently grappling with many obstacles, ranging from bureaucratic delays to issues with power purchase agreements (PPAs), leading to significant project implementation slowdowns.

The Southeast Asian economy considers the development of LNG power a matter of national energy security. According to Decision 500/QĐ-TTg, LNG power is expected to account for 14.9% of total power capacity, supplying 83 billion kWh by 2030.

However, the implementation of these projects faces numerous hurdles.

Challenges

La Hong Ky from the State Steering Committee Office for Energy Projects emphasised that these critical LNG power projects face various challenges that need to be resolved.

Ky highlighted that several provinces, such as Thanh Hoa, Nghe An, and Ninh Thuan, have yet to select investors, due to delays in investment policy approval and tendering processes. Additional challenges include land clearance, adjustments to local planning, land handover and leasing for project sites and transmission lines required to synchronise power evacuation.

For approved investors, securing financing remains a major challenge.

Most LNG power projects, except Nhon Trach 3 and 4, rely entirely on PPAs to obtain loans. However, none of the LNG power projects have successfully negotiated or signed PPAs with EVN (Vietnam Electricity) due to unresolved issues, including concerns over the stability of long-term energy quantity under contract (QC), transferring gas purchase commitments into power purchase agreements and aligning gas pricing mechanisms with electricity pricing.

Foreign investors also demand additional government guarantees, such as foreign currency conversion guarantees, payment guarantees, contract termination assurances with EVN and guarantees against delays in transmission line construction, he said.

According to Ky, synchronisation is vital for the success of LNG project chains. Yet, these projects are often subject to numerous uncontrollable external factors, prolonged timelines, technological and policy risks, involvement of multiple stakeholders, and a complex legal environment involving multiple laws. These challenges increase costs and project durations and create significant barriers for investors.

To ensure timely project implementation, he said the country must establish mechanisms and policies to address the outlined challenges and identify an appropriate energy structure.

Reforms

Nguyen Duc Tung from the Institute for Strategic Research and Industrial Policy proposed reviewing and refining the legal and management frameworks for LNG power projects. This involves amending regulations within Việt Nam's Investment Law, Bidding Law, Construction Law, Environmental Law and Planning Law to streamline project implementation. He added that clear and practical policies are essential to ensure effective management, build market access and distribution systems, and foster international cooperation.

He emphasised the importance of a dual strategy combining domestic gas exploration with imports to maintain a stable and long-term LNG supply. Prioritising the exploration and development of new gas fields will not only reduce dependence on imports but also unlock domestic resource potential.

Over the longer term, the country should explore the feasibility of establishing LNG production facilities, provided adequate technological, financial, and human resources are available.

Vietnam should also implement mechanisms for LNG imports and strategically position LNG power plants nationwide to minimise transportation costs and enhance fuel absorption efficiency. Additionally, transferring LNG pricing into electricity pricing within PPAs is fundamental to ensuring the economic viability and attractiveness of LNG power investments.

The country has identified 13 LNG power projects as critical infrastructure and approved by the Prime Minister./.

VNA

See more

At an automotive exhibition in Shanghai, China. (Photo: AFP/VNA)

Chinese electric vehicles drive back into Vietnamese market

About a decade ago, Chinese car brands like Zotye Z8, Beijing X7, and Brilliance V7 entered the Vietnamese market to limited success. But a new fleet of modern Chinese vehicles began to gain traction in the Vietnam market last year.

Illustrative image (Photo: VNA)

Nearly 16 trillion VND raised through January bond auctions

The January auctions saw a strong preference for 10-year and 15-year bonds, representing 80.2% and 14.8% of the total, respectively. Specifically, 10-year bonds raised 12.81 trillion VND, while 15-year bonds garnered 2.36 trillion VND.

Thang Long ferry at Cau Da port in Ba Ria - Vung Tau province. (Photo: VNA)

Vung Tau - Con Dao high-speed ferry reoperated

The high-speed ferry service connecting Vung Tau city and Con Dao island in the southern province of Ba Ria-Vung Tau and vice versa was resumed on February 7 by Phu Quoc Express JSC after a 5-month suspension.

At the working session between the Vietnam Directorate of Market Surveillance and the US Embassy over counterfeit Sunview-branded raisins in Hanoi on February 7. (Photo: dms.gov.vn)

Vietnam, US tackle counterfeit Sunview-branded raisins

Statistics showed that since 2024, there have been 27 documented cases involving Sunview raisins, resulting in fines of over 536 million VND (21,440 USD), primarily due to the sale of smuggled goods and products of unclear origin.

The VF3 model manufactured by VinFast is the most popular model in Vietnam's market. ( Photo courtesy of the company)

EVs will no longer be exempt from registration fees

Instead of enjoying a zero percent registration fee, battery-powered electric vehicles (EVs) will be required to pay 50% of the fee applicable to internal combustion engine cars with the same seating capacity.

Thuan An Fishing Port (Photo: tuoitrethudo.vn)

Thuan An fishing port opens, boosting Hue’s seafood industry

The second docking area of Thuan An Fishing Port has a minimum cargo handling capacity of 20,000 tonnes per year, and is capable of simultaneously accommodating 500 fishing vessels of at least six metres in length for docking and storm shelter.

Vietnamese prefer buying gold to mark God of Wealth Day (Photo: VNA)

Gold prices up again on God of Wealth Day

Gold prices surged significantly, exceeding the threshold of 90 million VND (3,550 USD) per tael at the opening session of the God of Wealth Day on February 7 (the 10th day of the first lunar month).
